How Top Down Estimation in Primavera P6 works

Top Down Estimation in Primavera P6

How Top Down Estimation in Primavera P6 works

Top Down Estimation in Primavera P6

In Primavera, there is a function called Top Down Estimation, which helps you calculate an estimated figure for Labor and Non-labor unit based on “estimation weights”. Top Down Estimation can be applied to both the WBS and Activity.

I will show you how Top Down Estimation works in Primavera P6.

Consider a simple project, where each activity is assigned the resource “Test”.

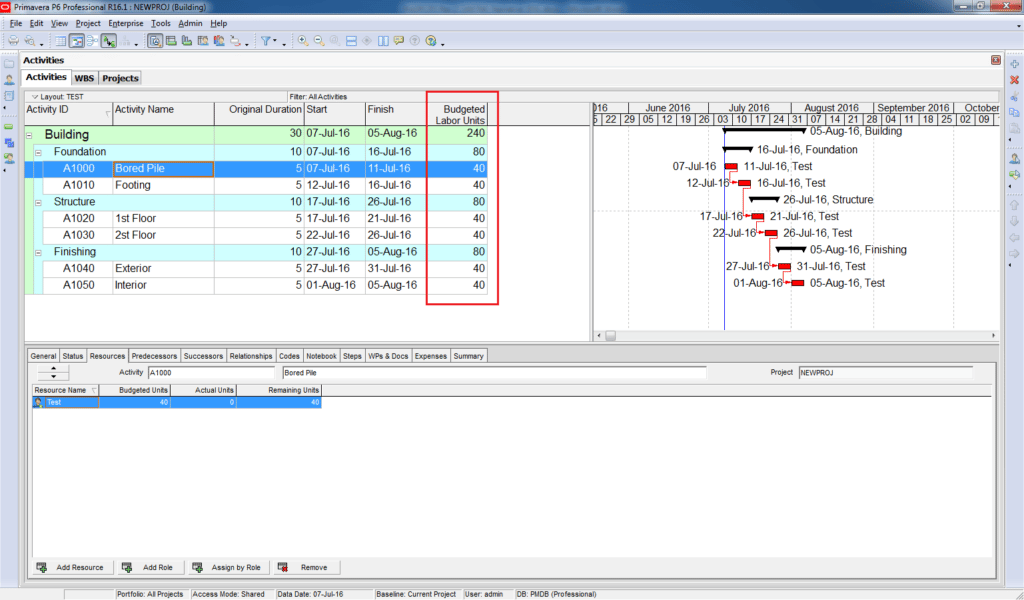

By default, each activity has 40 units.


We will use Top Down Estimation to redistribute the units to make it more realistic.

To perform top down estimation, you must first assign estimation weights to WBS and activities. These estimation weights are used to determine how units are distributed among WBS and activities.

Step 1:

Go to the WBS window and add the “Est Weight” as a column.


Step 2:

Now enter the weight for each WBS.


Step 3:

Next, go to the Activities window. Add “Est Weight” column.

P6 Top-Down Estimation- Image 04


Step 4:

Now enter the weight for each activity.

P6 Top-Down Estimation- Image 05


Step 5:

Go to Tool -> Top Down Estimation


Step 6:

Primavera displays the current units in your project. Now you can enter the new units you want to apply to your project.


Step 7:

Click on the Apply button.

Now you can see WBS and activities have new budgeted units.

P6 Top-Down Estimation- Image 08

The units are distributed according to Est Weight that you assigned.

For example: Foundation get 40% of 1000 units = 400 units. Bored Pile get 70% of 400 units = 280 units.

I hope now you have a better idea of how Top down estimation works in Primavera P6.

If you have any question, please post them down below. I will make sure that I will go through as many questions as I can and assist you in answering your questions.

Additional Resources:

If you are keen on mastering your skills in project scheduling with Primavera P6 and getting equipped with new and proven strategies in cutting the time in schedule development, updating, and reporting, check this comprehensive and hands-on training program offered by Project Control Academy; Practical Project Scheduling with Primavera P6 Online Training.


Practical Project Scheduling with Primavera P6 Online Training


About the Author, Khuong Do

Khuong Do is a Project Planner in Civil Engineering, Transportation, and Oil & Gas Industry. He has worked as a Primavera Consultant Specialist since 2006 and willing to share his passion for Primavera through lots of Tips & Trick on his personal blog.

He holds a Civil Engineering degree and a Bachelor of Information Management System. Now he is working in Petronas RAPID project, one of the biggest Refinery and Petrochemical complex, in Pengerang – Malaysia

Recent Blog Posts

AI is moving fast, but many project controls teams are still stuck with scattered files, manual reports, reactive reviews, and delayed insights. This article shows six practical AI shifts that can help you save time, improve analysis, and build the skills needed to stay ahead.

Read More »
Project scheduler reviewing a Gantt chart for forensic schedule analysis, delay analysis, and critical path impact in a project delay claim.

Learn the difference between delay analysis and forensic schedule analysis, and why schedulers, planners, and project controls professionals must prove causation, critical path impact, and delay entitlement.

Read More »
AI in Project Controls: Are You Preparing for the Future—or Falling Behind?

AI in Project Controls is transforming how we manage projects. Learn what it is, why it matters, and how to prepare to stay ahead.

Read More »

Think EVM is only for government projects or too complex? Discover the truth behind the most common Earned Value Management Myths.

Read More »

Learn how to integrate project controls into contract management—from scope and risk alignment to change control—for better project delivery.

Read More »
The Best Project Controls Conferences

Are you considering attending a Project Controls conference in 2025? Whether you’re looking to sharpen your skills, discover the latest industry trends, or connect with like-minded professionals, conferences are one of the best ways to elevate your career. Every time I attend a conference, I’m reminded of how energizing and

Read More »

InEight and Project Control Academy have joined forces in a strategic partnership aimed at advancing and standardizing technology implementation best practices in the field of project controls.

Read More »
Excelling in Your Project Professional Career: The Secret to True Leadership and Success

Discover how to excel in your project career by mastering the secrets of effective leadership. Learn how communication, influence, and emotional intelligence can fast-track your success.

Read More »
LinkedIn
Facebook
Twitter
WhatsApp
Email
>
